AAPEX service equipment installation sequence banner

/

/

How to Sequence Freight and Equipment Installation for AAPEX

How to Sequence Freight and Equipment Installation for AAPEX

Published:

In This Article

This article explains how to move lifts, vehicles, tools, screens, and service equipment into an AAPEX booth without blocking unfinished work. It covers utility preparation, access clearances, crate order, technician space, buyer visibility, and the final demonstration check.

  • Confirm equipment size, weight, access, utilities, and final position before shipping.

  • Finish flooring, structure, power, air, data, and lighting before heavy equipment arrives.

  • Place lifts and large service units before moving the vehicle into position.

  • Label crates by booth zone and open them in the order each item is needed.

  • Keep technician access, buyer sightlines, service panels, and safety clearances open.

  • Run the complete demo and reset process before the show opens.

What should be installed first for an AAPEX equipment demo?

For an AAPEX equipment demo, finish the flooring, booth structure, and utilities before heavy equipment arrives. Power, compressed air, data, and lighting should be ready before lifts and service units move into place. The vehicle, tools, screens, and graphics come later, followed by a full check of the equipment, working clearances, buyer visibility, and reset process.

AAPEX service-equipment booths may include lifts, vehicles, tools, diagnostic units, screens, and several utility connections. If a large unit arrives too early, it can block flooring, power, compressed air, cable routes, or the access needed for the next piece of equipment.

The installation order should be settled before freight leaves the warehouse. Dimensions, weight, clearances, utility needs, final placement, and crate order all affect when each item can enter the booth. This is especially important for AAPEX Joe’s Garage, where technicians need room to work while buyers watch from outside the operating area.

What to Confirm Before Shipping

Before a lift, vehicle, or service unit leaves the warehouse, confirm its dimensions, weight, final position, and route into the booth. A floor plan may show enough space, but the crate can still be too wide for an access point or difficult to turn into place.

Power, compressed air, data, exhaust, anchoring, and connection points should match the final equipment position so cables, hoses, and supports do not need to be moved later.

Before the Equipment Leaves the Warehouse

  • Final dimensions and shipping weight

  • Crate size and handling points

  • Door, aisle, turning, and overhead clearances

  • Power, air, data, and exhaust needs

  • Anchoring and connection locations

  • Final booth position and orientation

  • Test tools, adapters, and backup parts

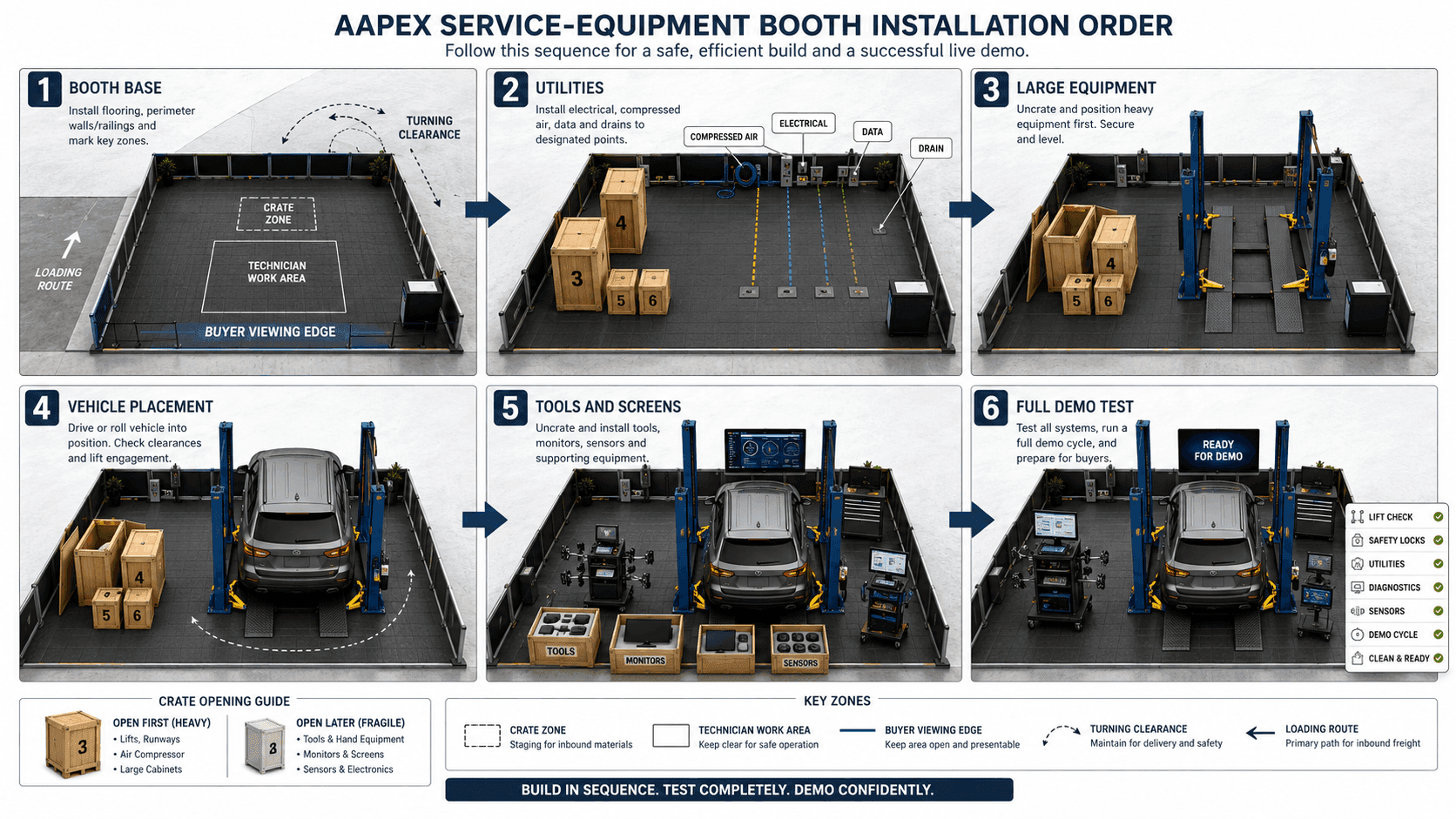

AAPEX equipment and vehicle installation sequence diagram

Flooring, utilities, and structural work should be completed before lifts, vehicles, and other large service equipment move into position.

Structure and Utilities Come First

Finish the flooring, booth structure, power, compressed air, data, and lighting before lifts, vehicles, or large service units are moved into place. Heavy equipment can block cable runs, air lines, floor work, and access to structural connections once it is positioned.

Mark the final location and service points early, but keep the area open until the work underneath and behind the equipment is complete.

Before Large Equipment Moves In

Large equipment is rarely easy to move once the surrounding display is built. Bring it into the booth only after the base work, utilities, and access path are ready.

AAPEX service equipment and vehicle installation sequence

The booth base and utilities come first, followed by large equipment, vehicle placement, tools, screens, and a complete demo test.

When Equipment and Vehicles Should Enter the Booth

Lifts and other large shop equipment usually enter before the vehicle. They need more room to turn, align, and connect, and become harder to position once the booth starts filling up.

Check the full route from the loading point to the final location, including doors, aisles, overhead clearance, and turning space. The final sequence should also leave technicians enough room to work and buyers a clear view of the demonstration.

Recommended Installation Sequence

Stage

What happens

What needs to be ready

Booth base

Flooring and structural elements are installed

Final layout and equipment route

Utilities

Power, compressed air, data, and lighting are connected

Service locations and connection points

Large equipment

Lifts and shop equipment move into position

Base work and utilities completed

Vehicle placement

The vehicle enters its final demo position

Equipment connected and delivery route clear

Tools and screens

Tools, monitors, sensors, and fragile items are added

Heavy installation and vehicle placement finished

Full demo test

Equipment, utilities, visibility, and reset steps are checked

All devices and services operating

Match Each Crate to Its Final Booth Zone

Number crates by the booth zone they serve, not just by shipping order. Each label should show the equipment or display area, its final position, and whether the crate needs to open early or remain closed until the heavy work is finished.

Keep flooring, utility, support, and large-equipment crates easy to reach. Tools, screens, sensors, and other fragile items can come in later. Empty crates should leave without blocking power, air, data work, or the remaining delivery path.

The crate map should be finalized alongside freight timing, unloading, and pre-show coordination so each item reaches the correct booth zone in the right order.

Keep Technician Access and Buyer Sightlines Clear

Technicians need room to reach controls, tools, and service points without stepping over cables or working around furniture. Power, air, and data lines should stay clear of the main work area while remaining accessible for checks.

Buyers should be able to watch from outside the operating zone. Keep service panels, equipment doors, emergency access, and safety clearances open after vehicles, screens, counters, and barriers are in place.

AAPEX service equipment and vehicle installation sequence

The booth base and utilities come first, followed by large equipment, vehicle placement, tools, screens, and a complete demo test.

Run the Full Demo Before Opening

Run the demo the same way the team will present it during the show. Check the equipment, power, compressed air, screens, vehicle position, and technician workspace under normal operating conditions.

Make sure buyers can see the important steps without entering the work area. Confirm the reset process and keep essential tools, adapters, and spare parts close enough to handle a minor failure without stopping the demonstration.

FAQ

What should be installed first in a Joe’s Garage booth?

Finish the flooring, structure, power, compressed air, data, and lighting before large equipment moves in. This keeps service connections open and prevents lifts or vehicles from blocking unfinished work.

When should vehicles and lifts enter the booth?

Lifts and other large shop equipment usually enter before the vehicle because they need more room to turn, align, and connect. The vehicle can move into position once the equipment is secured and the access route remains clear.

What should be tested before AAPEX opens?

Run the demo under normal show conditions. Check equipment function, utilities, vehicle position, technician access, buyer visibility, reset time, and the spare parts needed to keep it running.

Planning an AAPEX Service-Equipment Booth?
